00Landscape
Back to Home

North Summit Hydro

Site Story · Nyadi-Phidi, Lamjung

Building tomorrow's power

From the valley to the penstock: how the plant is being built, told from the site.

The Nyadi at the headworks, filmed from the construction site.

00The valley

The landscape before construction

Nyadi-Phidi Site Landscape Drone Footage

Before tunnels, contracts, and machinery, the story begins with the valley itself. Aerial footage shows the scale, the elevation, and the river alignment that shapes every engineering decision at Nyadi-Phidi.

Watch the full aerial

01The valley outpost

Establishing Base Camp

Where vision meets the valley

Bunker built to store explosives for site blasting

Nestled in the foothills of the Annapurna range, the site office is the nerve centre of the operation. A military-protected camp holds the valley, and a dedicated bunker stores the explosives that open the rock. From this outpost, engineers coordinate every drill, every blast, and every pour of concrete.

Command hub · Explosives bunker · Army camp

Every great journey begins with a single step. Ours began here.
Site office at the project base camp

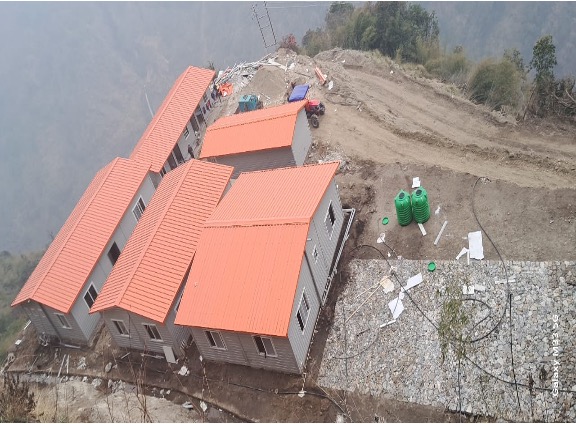

Project base camp in the valley

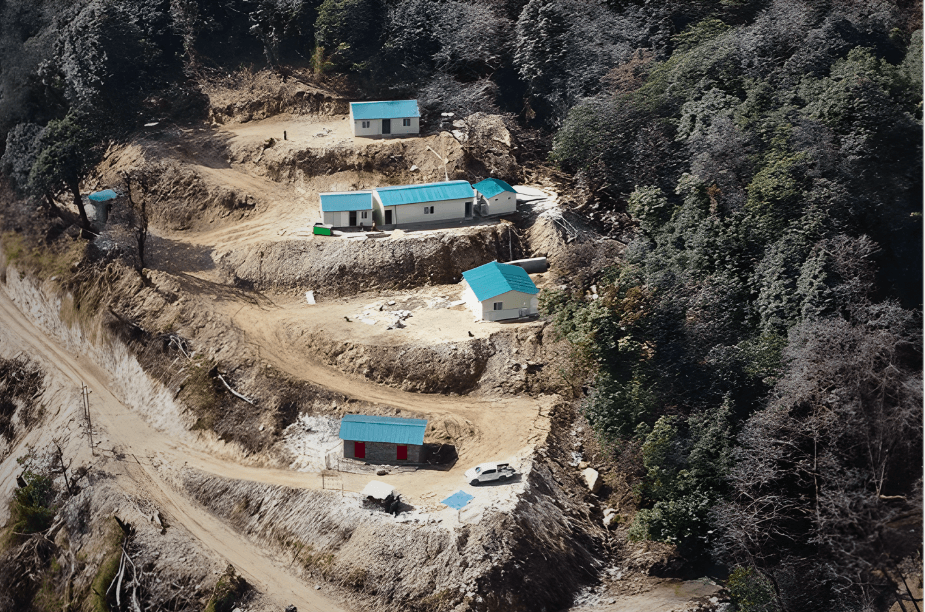

Army camp established to secure the construction site

Continued in Road & Logistics

02The supply line open

Road & Logistics

Connecting the valley to the mountain

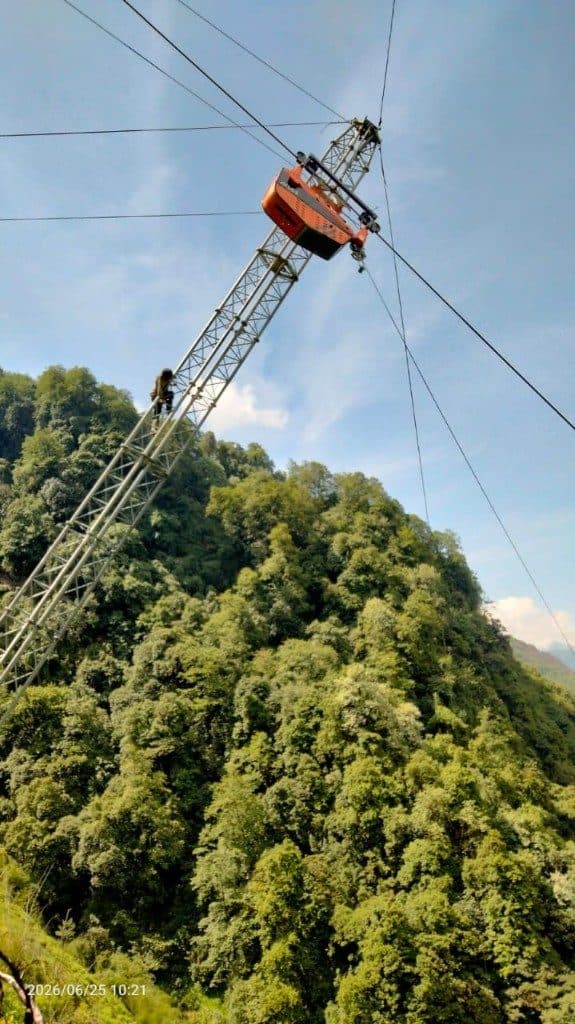

Cable crane being tested on the ropeway above the forested slope

The supply line is open. The mountain track to the headworks is complete, and the Bailey bridge across the river now carries excavators and crews to the powerhouse. Three steel ropeway towers stand on the slope, and the cable crane has been lifted onto the line and tested, the lift that ferries cement, steel, and tools where trucks cannot climb.

Access bridge · Cable crane tested · Ropeway towers

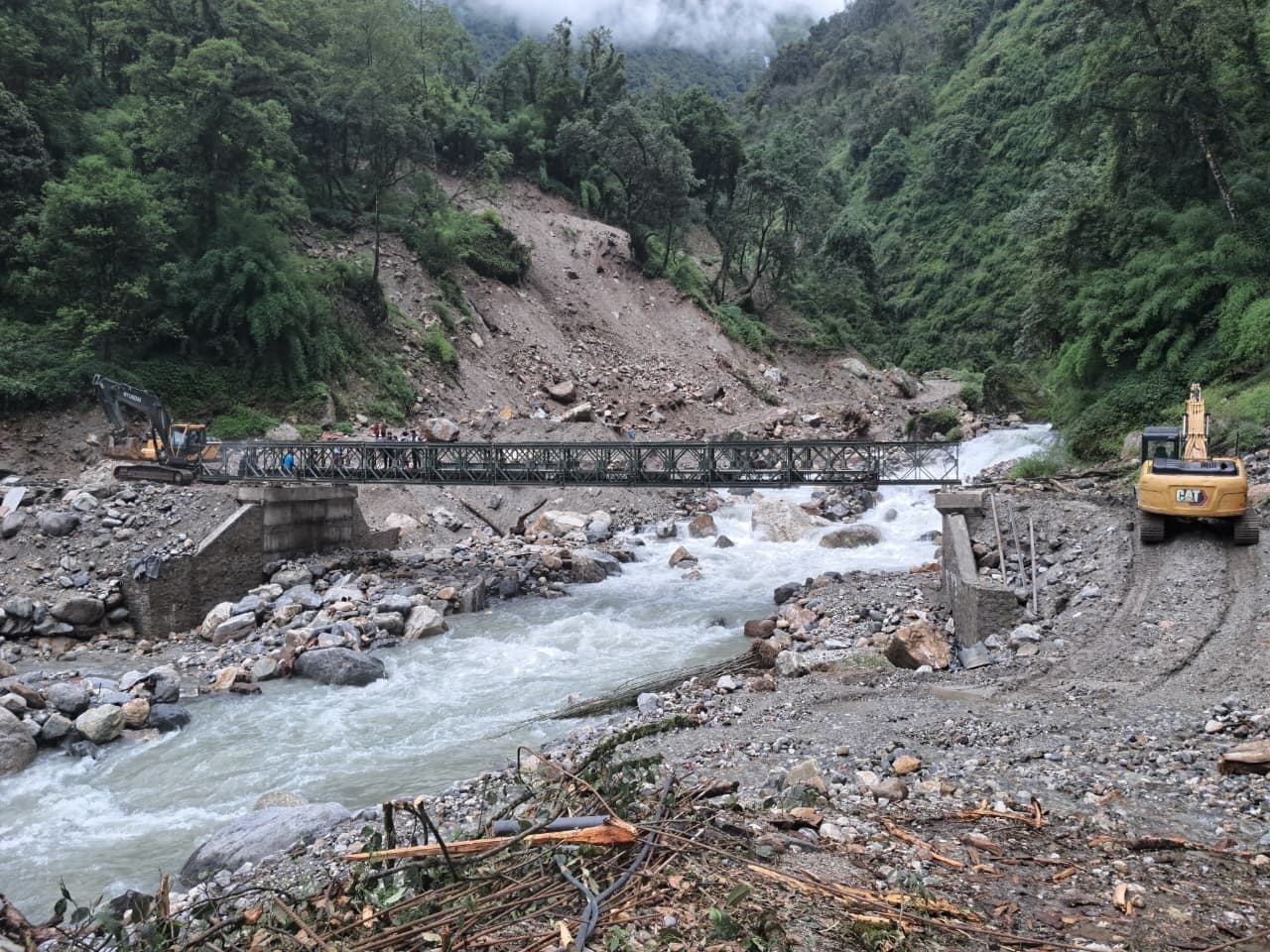

Bailey bridge carrying plant across the river to the powerhouse

Ropeway tower 2 standing on the slope with cables tensioned

Road upgradation towards the headwork area

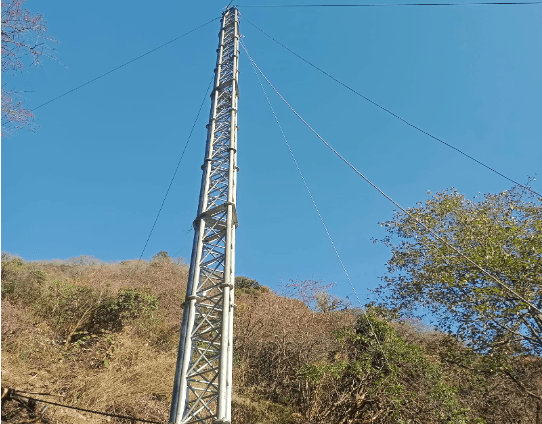

Ropeway tower for material transport to the site

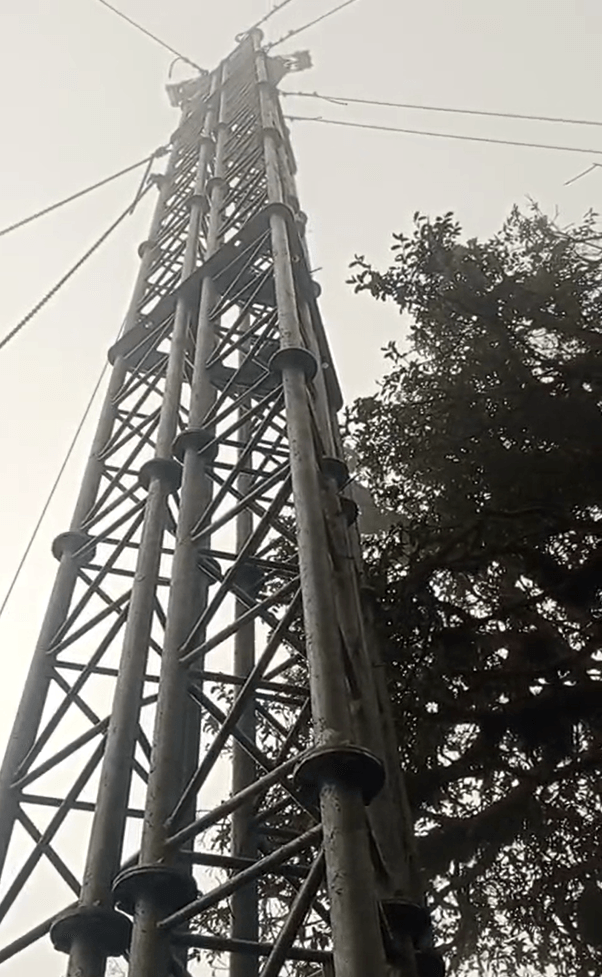

Erected Tower 3 of the ropeway system

Continued in The Head Intake Site

03Where the river is guided

The Head Intake Site

Where Nyadi Khola meets engineering

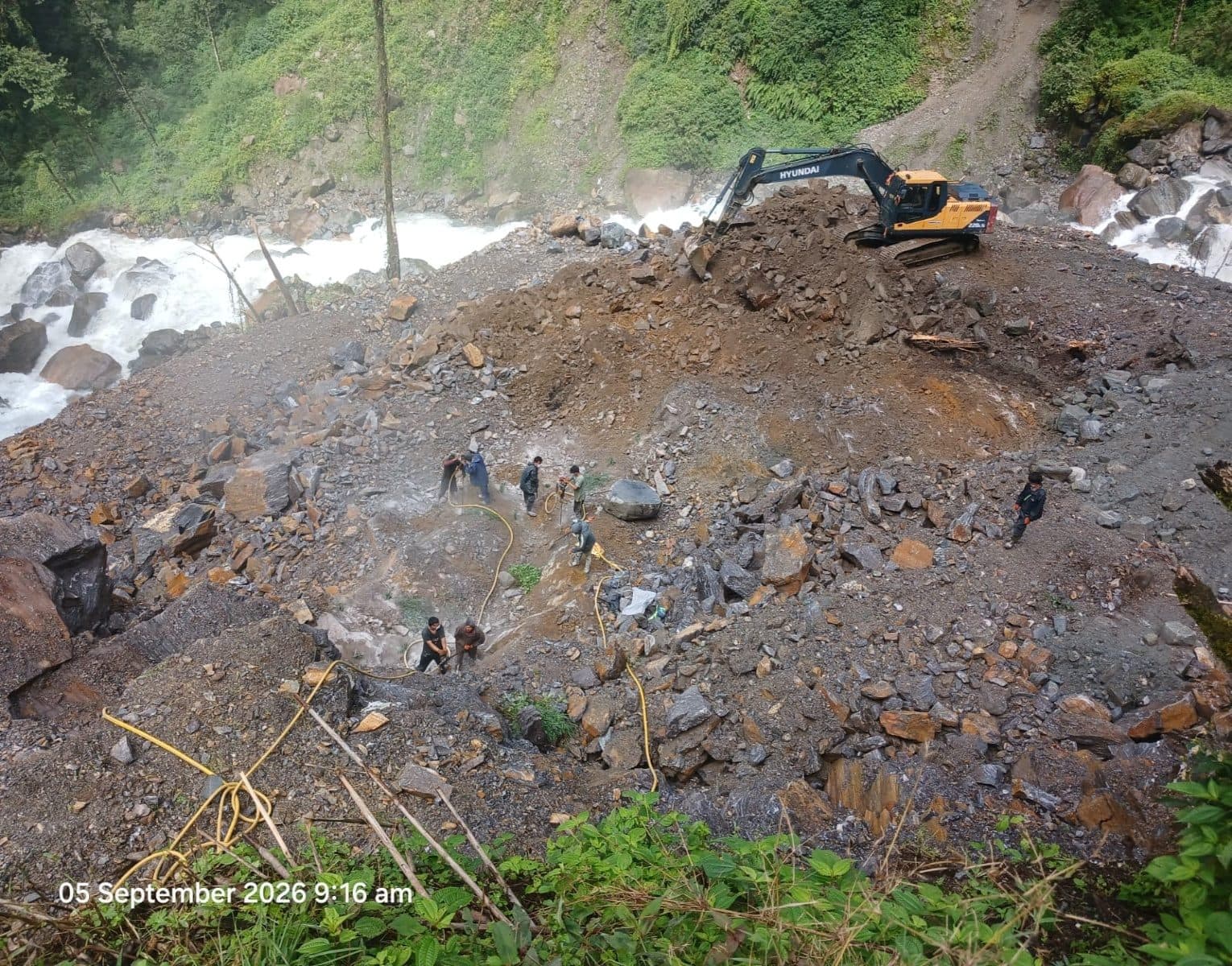

Completed desander excavation at the headworks

The Nyadi has been turned aside. First-stage river diversion is complete, and the undersluice is rising in reinforcement and formwork beside the diverted channel. Desander excavation is finished, ready for the basin that will keep sediment out of the conveyance. Survey base stations and a transformer at the headworks keep the work precise and powered.

River diverted · Undersluice rising · Desander excavated

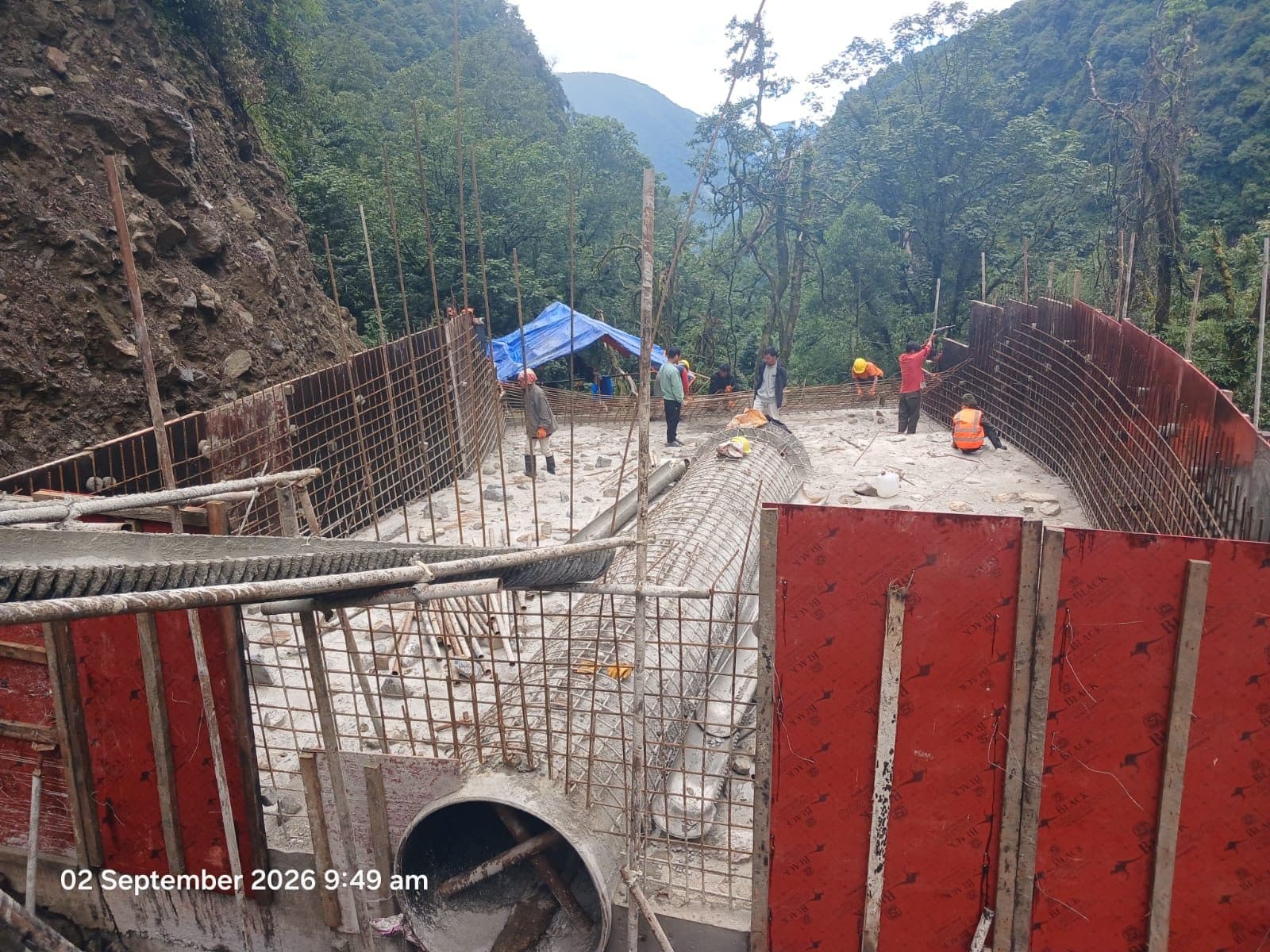

Undersluice under construction, with reinforcement and formwork beside the river
Head intake site on the Nyadi Khola river

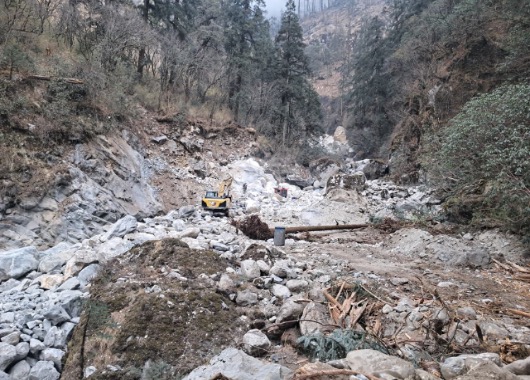

Boulder clearing work at the intake area
Drilling on boulders at the intake area
Diverted river channel at the weir area

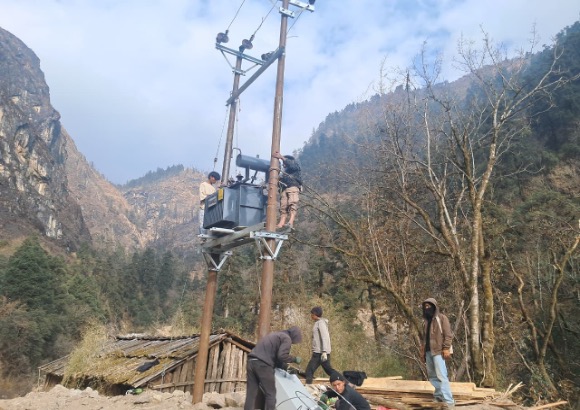

Transformer installed at the headworks area
Desander basin and inlet portal construction

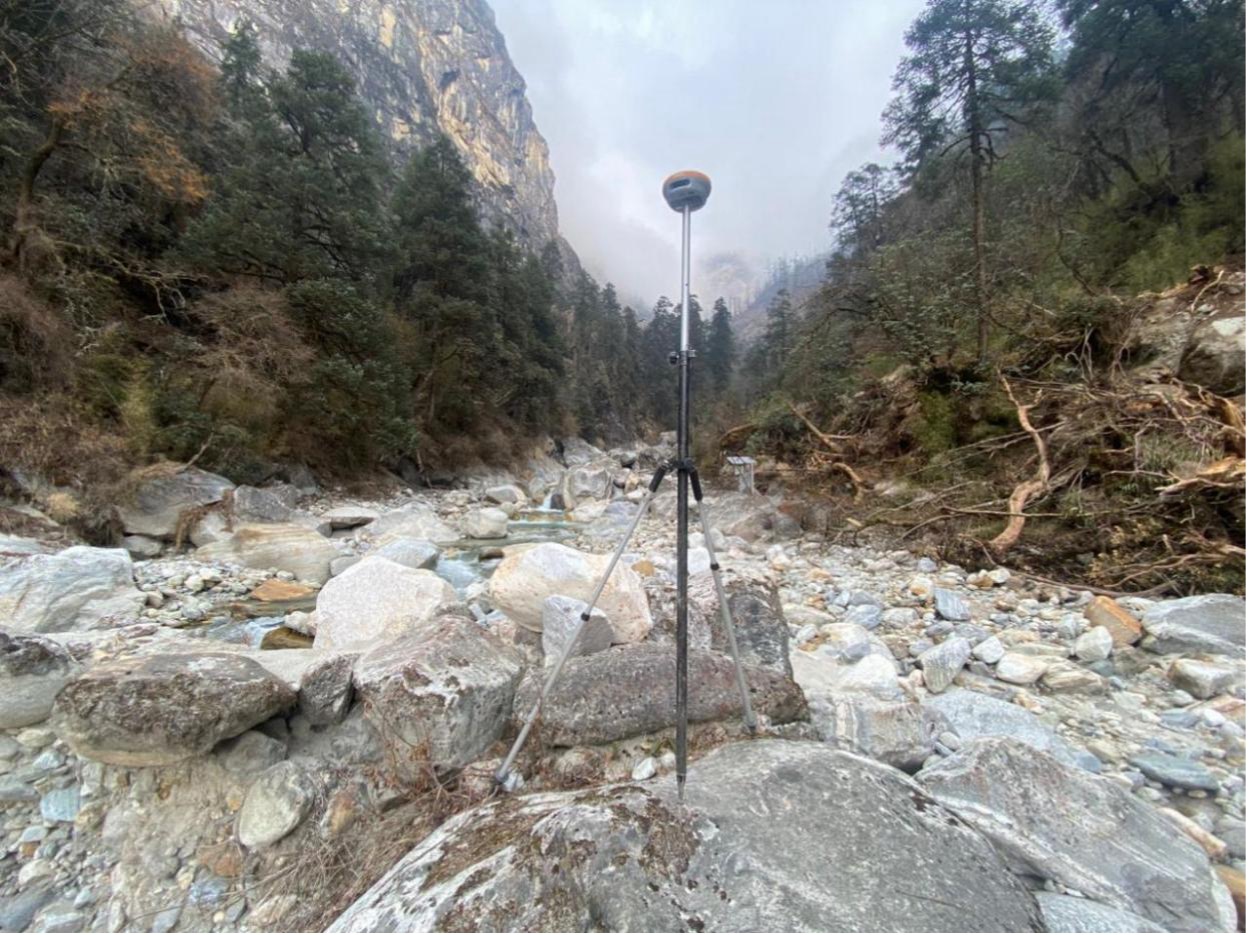

Surveying and base station development at the headworks

Continued in Piercing the Earth

04Two tunnels, one mountain

Piercing the Earth

Headrace inlet open; penstock tunnel through

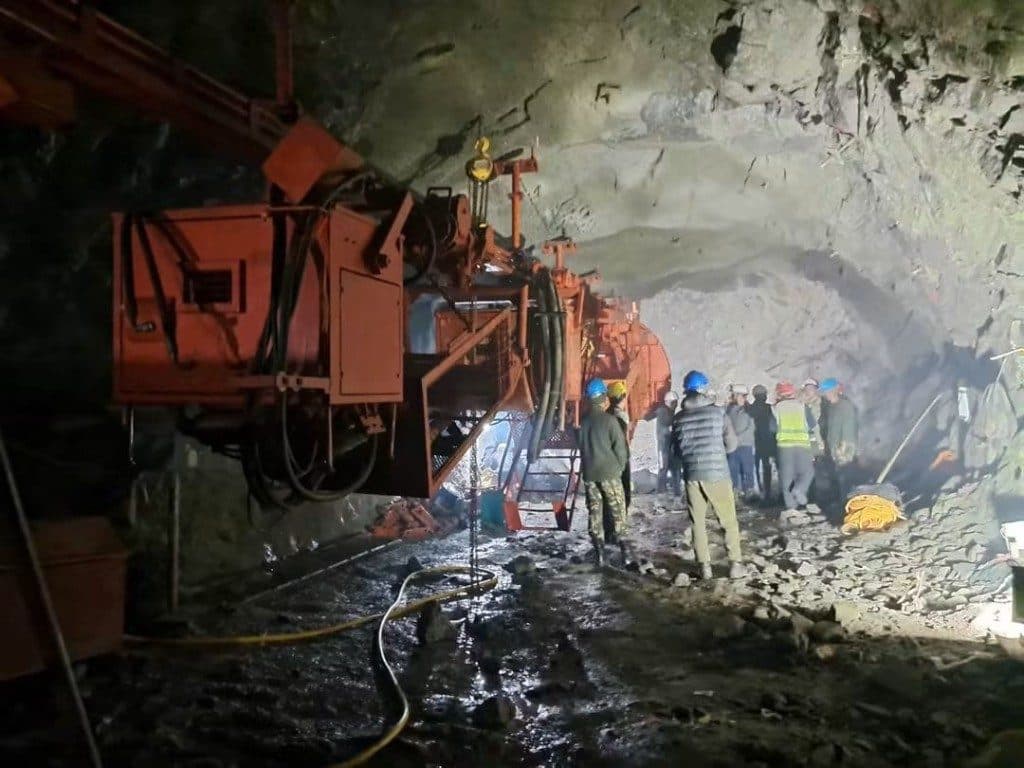

Drill jumbo and crew at the horizontal tunnel face

Two tunnels now tell the underground story. A drill jumbo works the horizontal face, boring the next round before the rock is supported. Excavation of the 253-metre penstock tunnel is complete. The longer headrace, 2,020 metres by design, is the live face: the inlet portal is open, and as of the August progress report 119.85 metres have been driven, with shotcrete support underway inside the inlet.

Horizontal drilling · Headrace at 119.85 m · Shotcrete support

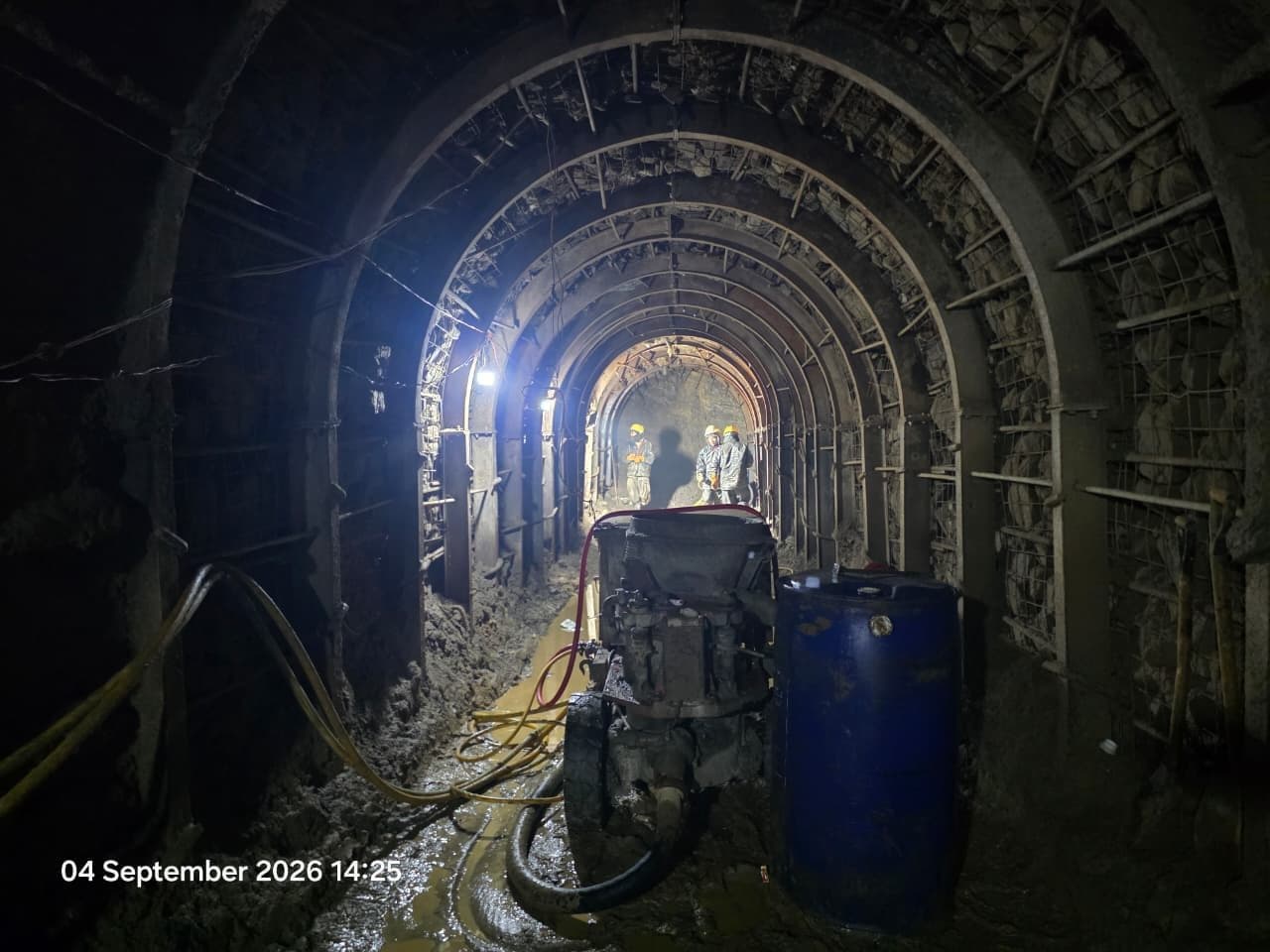

Shotcrete preparation inside the headrace inlet tunnel

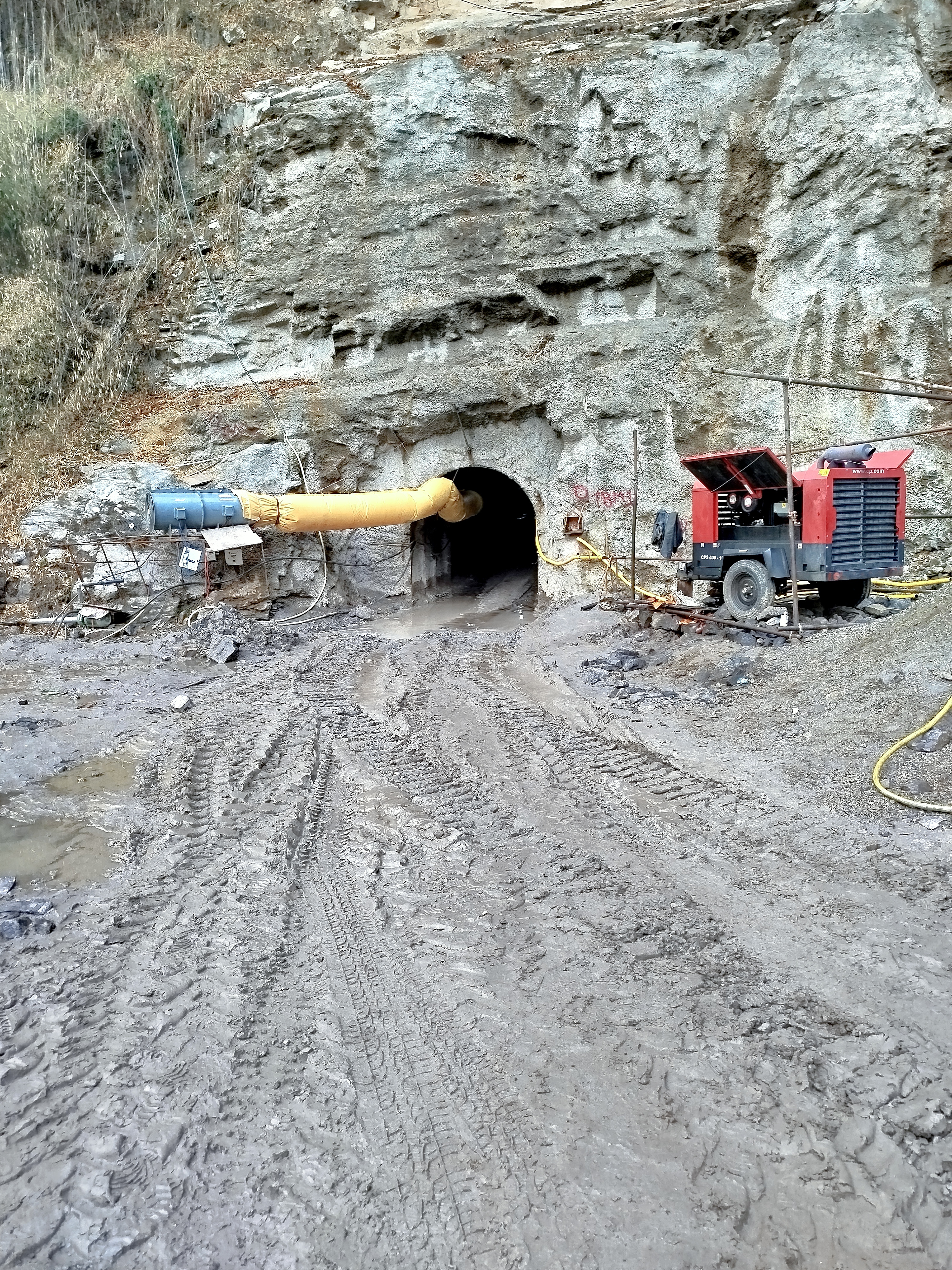

Entrance of the horizontal tunnel

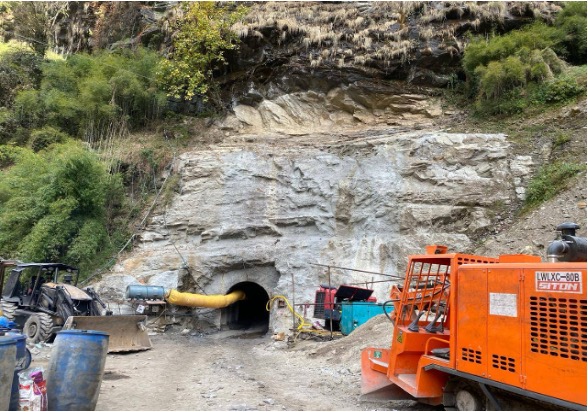

Entrance to the penstock tunnel
Inside the tunnel during construction

Continued in Where Light Turns Vertical

05The drop toward the penstock

Where Light Turns Vertical

The shaft that connects tunnel to penstock

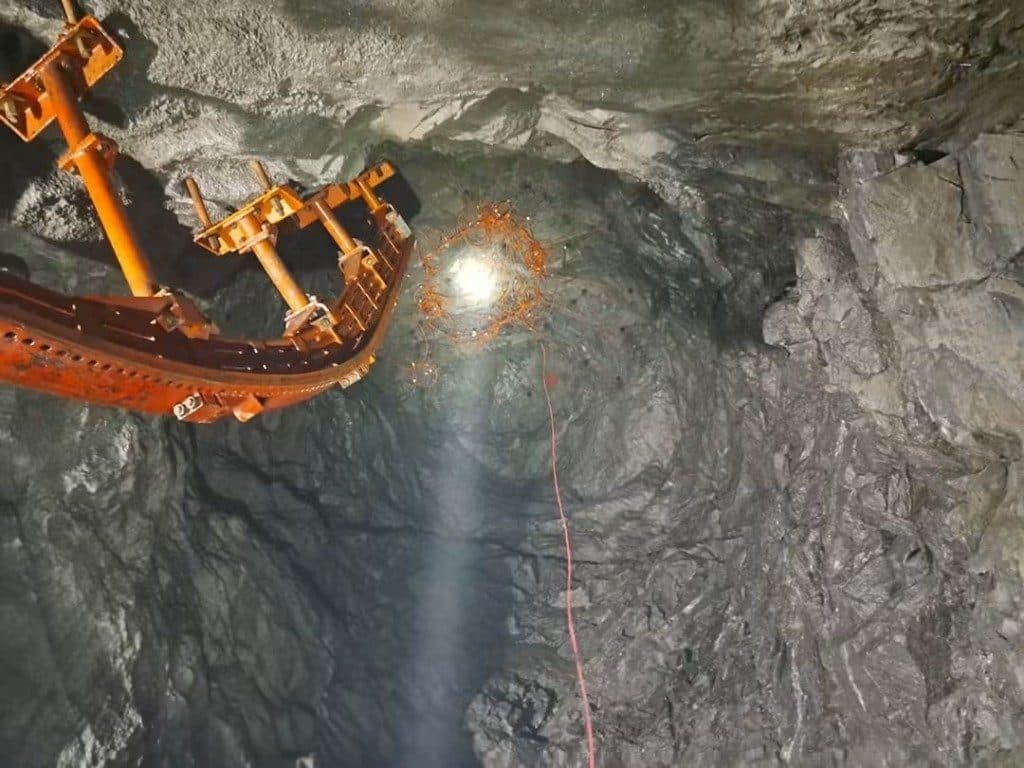

Vertical drilling up the shaft, looking toward the charged rock face

The horizontal drive has turned, and the shaft is drilled upward through the mountain. At the end of the 253-metre penstock tunnel, the raise drill works toward daylight, with 250.55 metres of the 255-metre vertical shaft already excavated as of the August progress report. From here the water will fall 690 metres, converting the mountain's head into power.

Vertical drilling · 250.55 m of 255 m · 690m gross head

At this depth, every bolt and every brace must be flawless. There is no room for error inside a mountain.

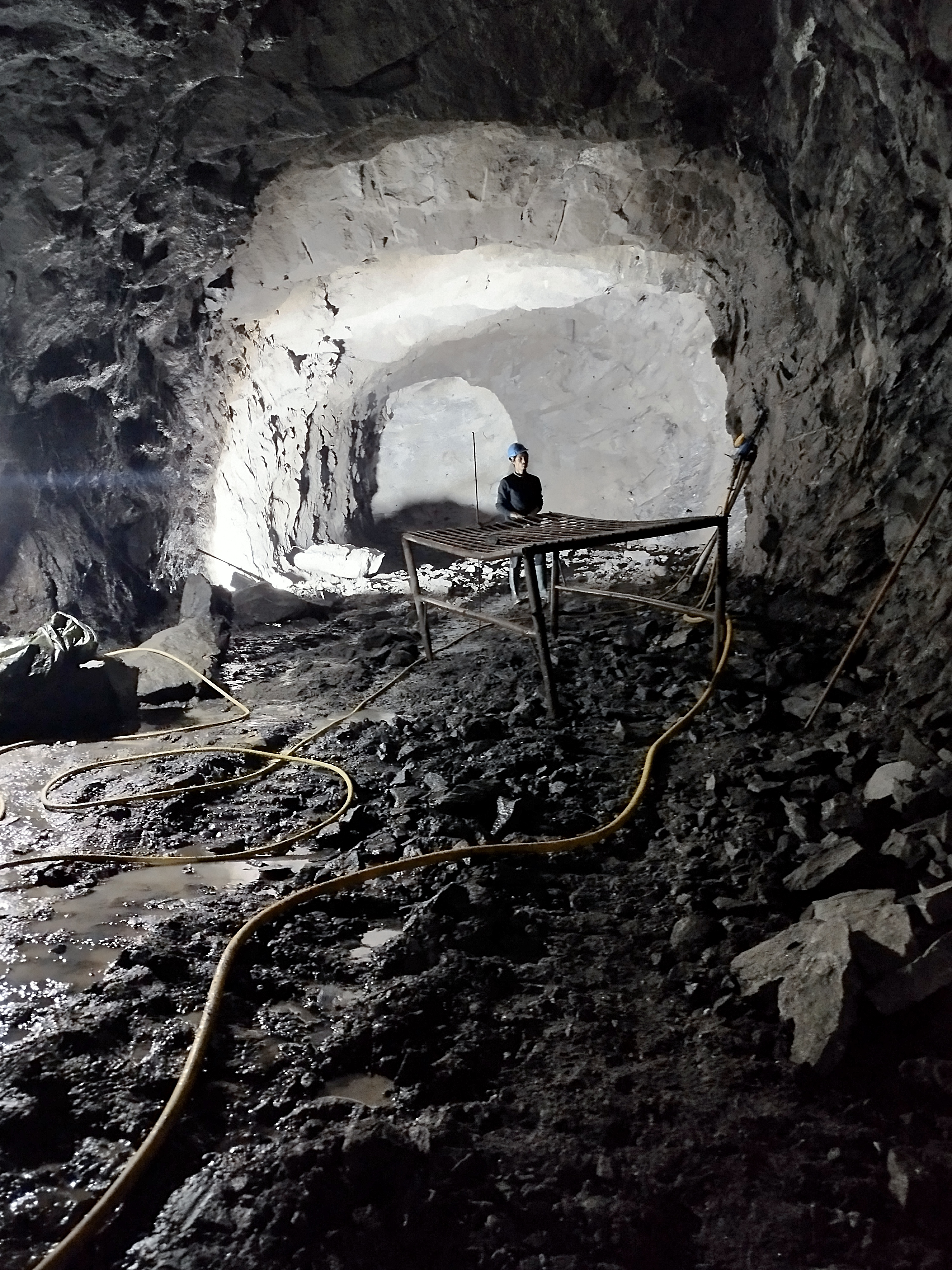

End of the horizontal tunnel at the vertical shaft

Continued in Forging the Penstock

06Steel, concrete, momentum

Forging the Penstock

Steel arteries of the mountain

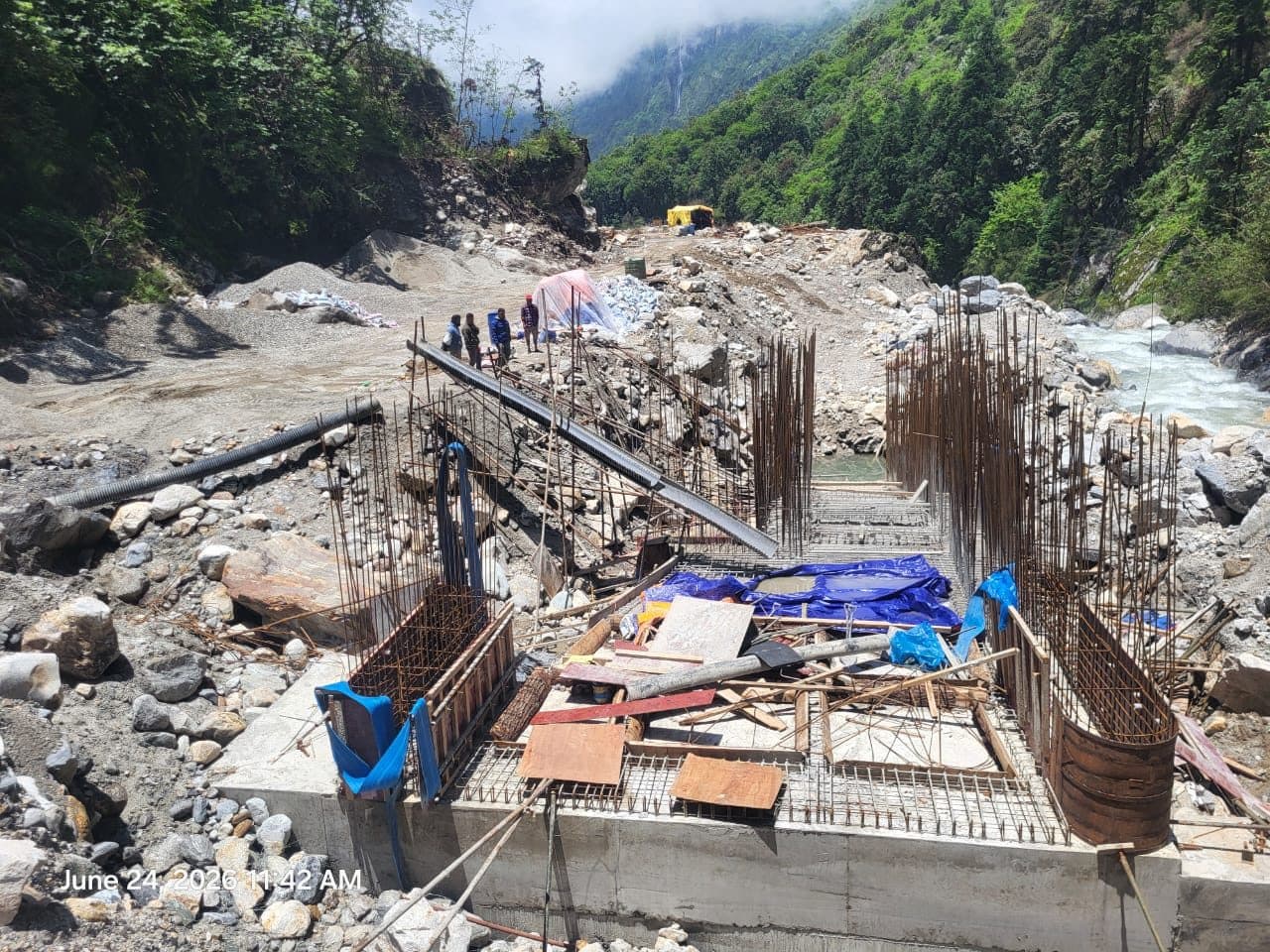

Powerhouse excavation beside the river, with an excavator and drill crews

The mountainside is no longer only an alignment. At the hydromechanical yard, fabricated penstock pipes are stacked in their hundreds, welded and waiting to be placed. Anchor Block 9 has been poured; Anchor Block 12 stands in reinforcement and curved formwork, a steel pipe already sleeved through the pour. Below, at the confluence, excavators and drill crews are opening the powerhouse foundation beside the river.

Anchor blocks · Pipe fabrication · Powerhouse excavation

Each pipe carries not just water, but the promise of light for an entire region.
Reinforcement and curved formwork at Anchor Block 12

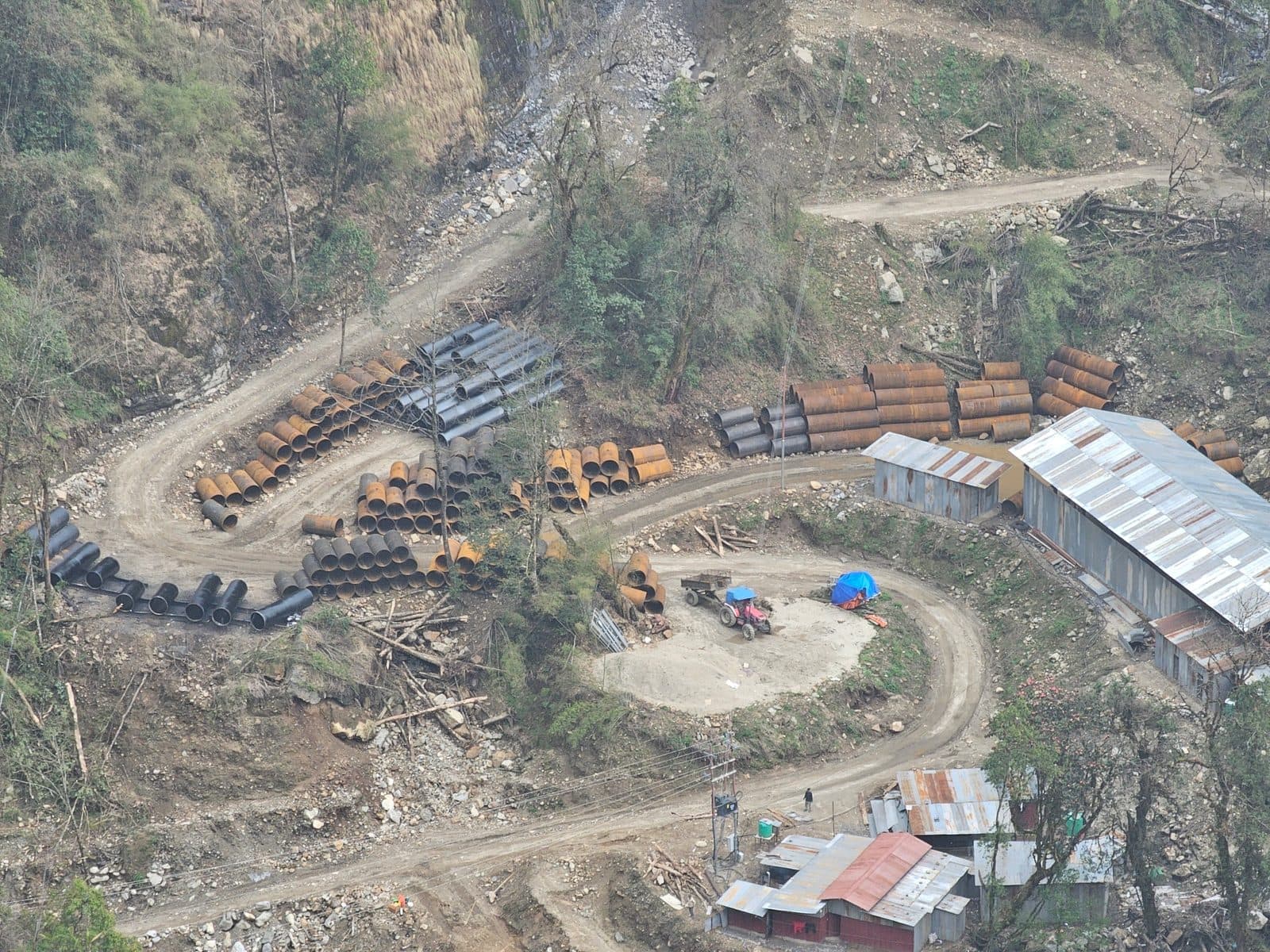

Hydromechanical yard with stacked penstock pipes ready for placement

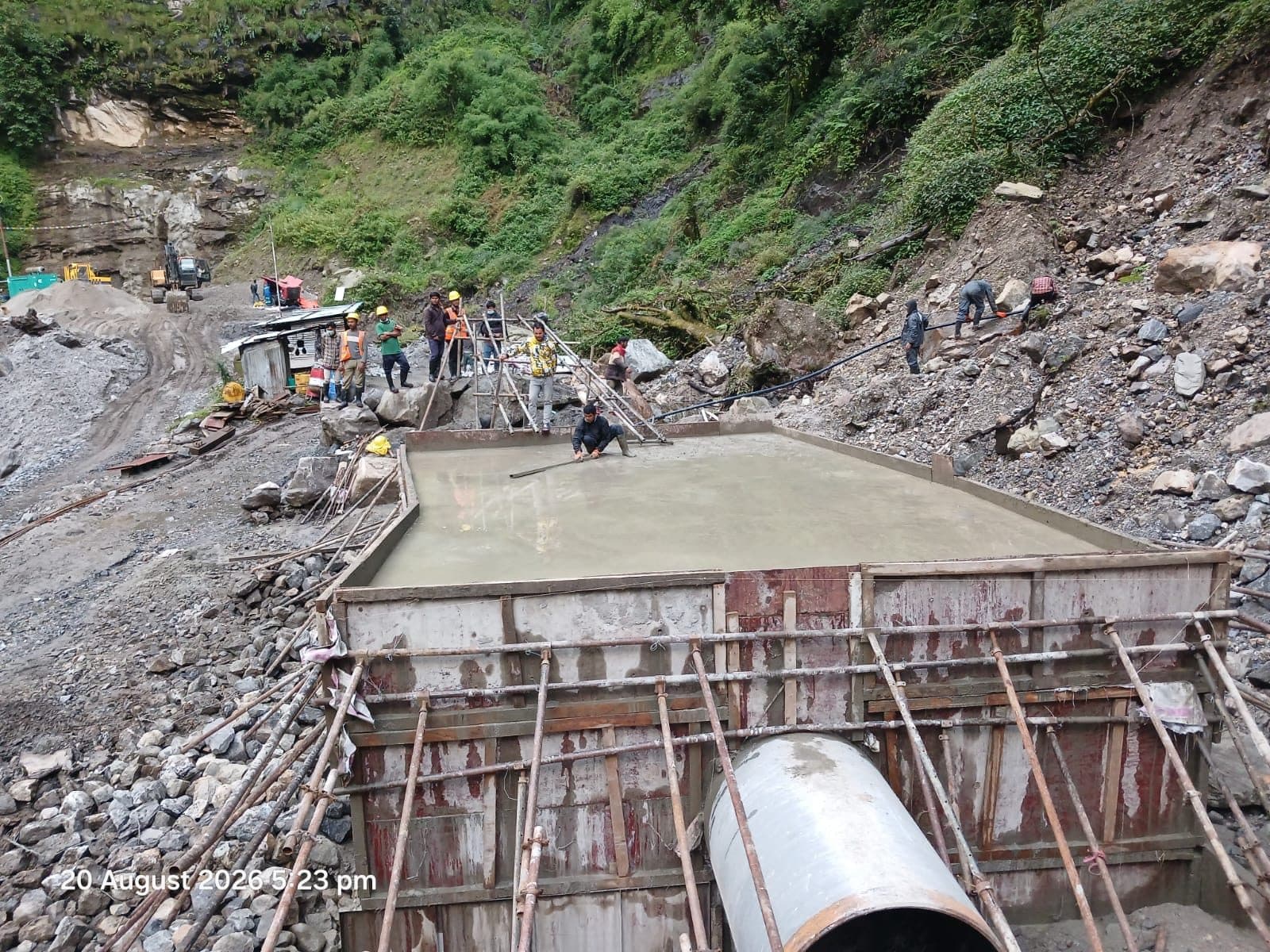

Completed concrete pour at Anchor Block 9

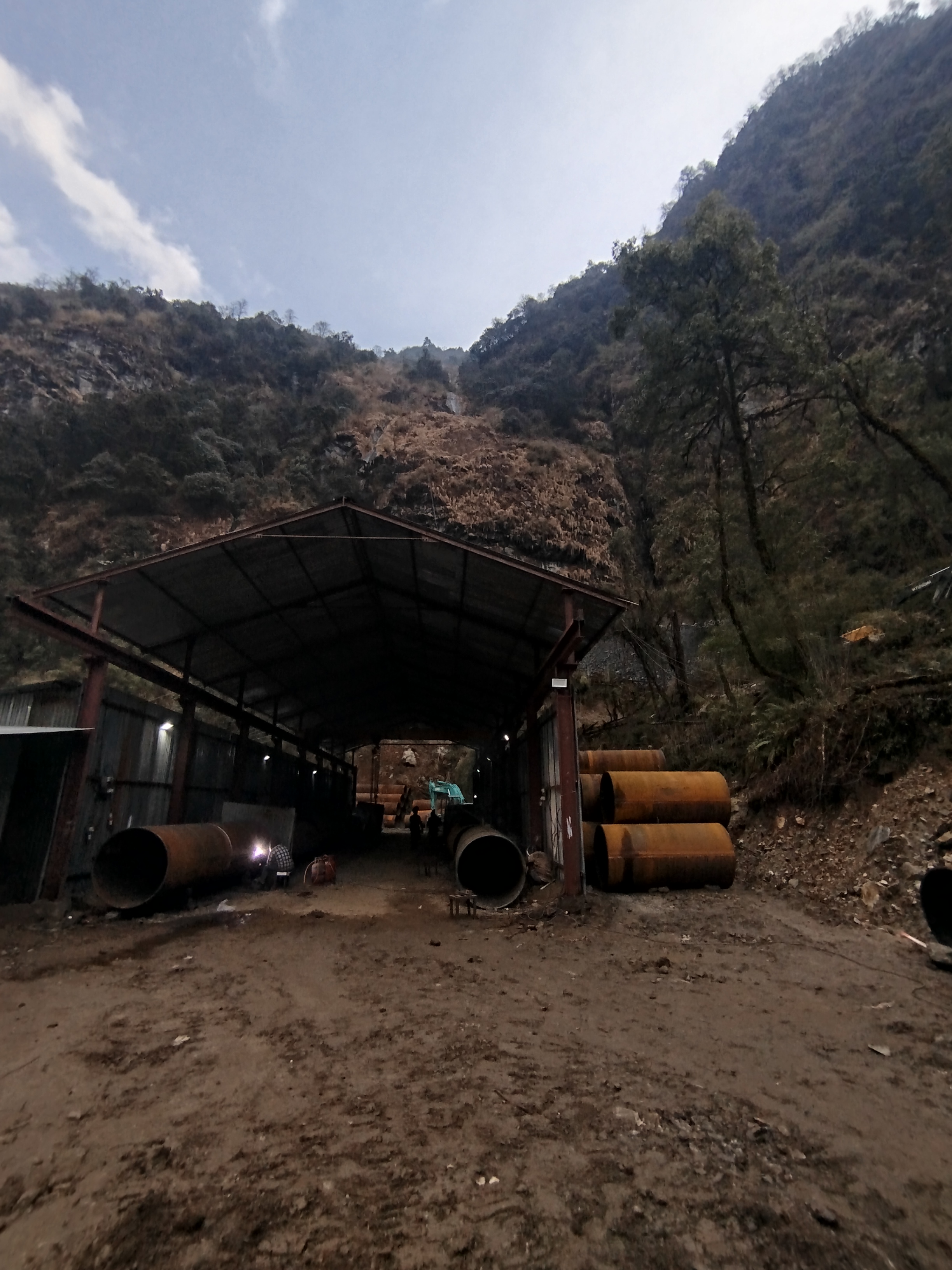

Penstock pipe fabrication on site

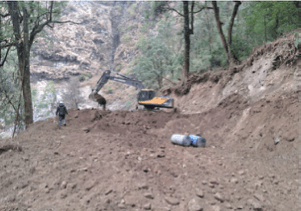

Excavation work for the penstock alignment

Construction material preparation at the project site
Bridge foundation work for the powerhouse
Penstock pipe fabrication and construction yard

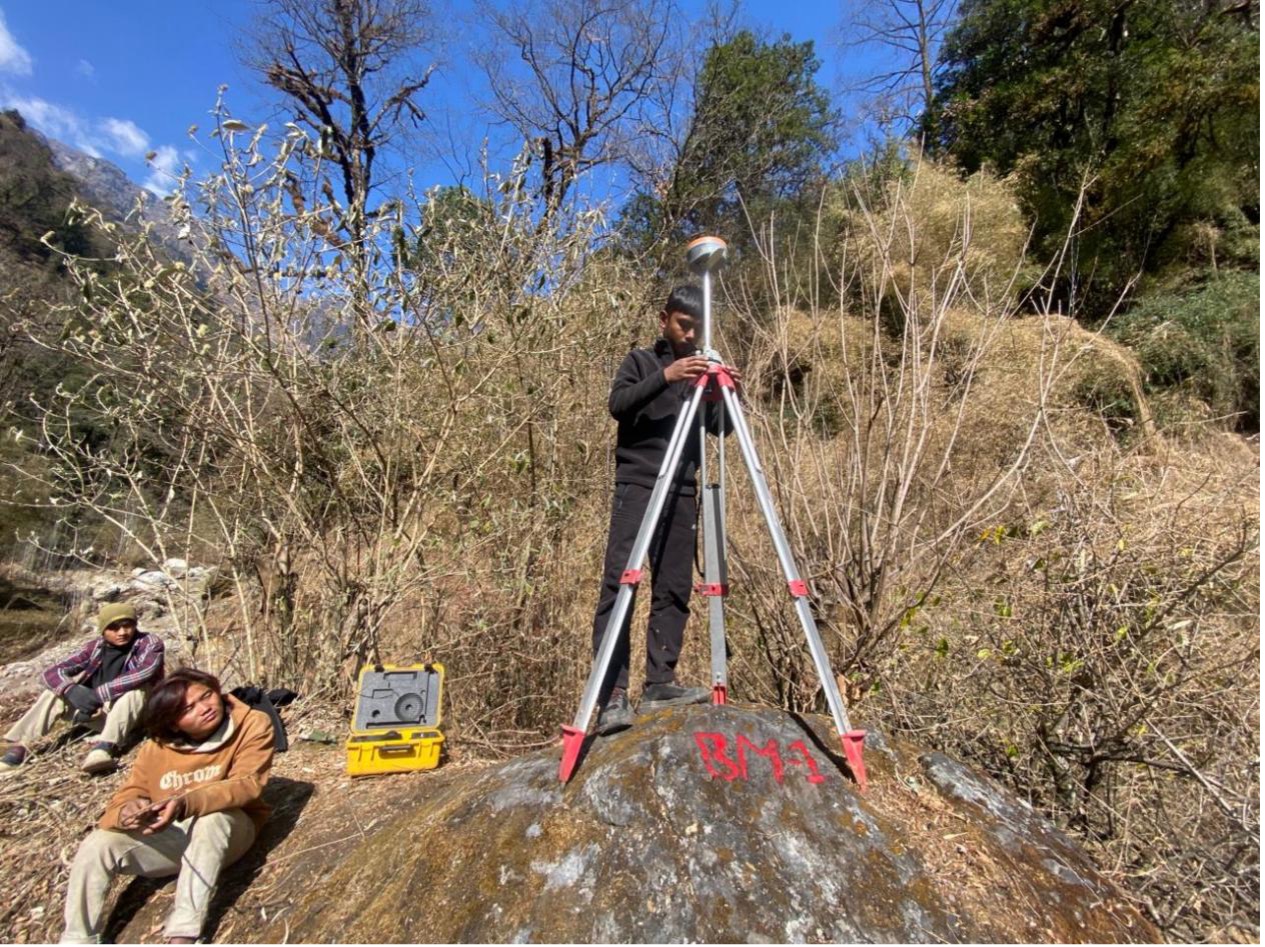

Surveying and base station development near the powerhouse

The plant, in figures

Installed capacity
21.4 MW
Annual generation after outage
122.94 GWh/yr
Gross head
690 m
